Location: Hopewell, NJ
The Problems:
- Insufficient Storage and Living Space
The Goal:
The primary goal of this project is to expand the home to better accommodate a growing family.

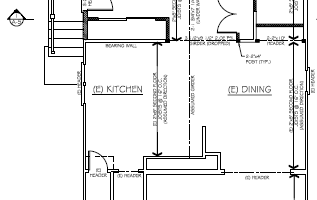

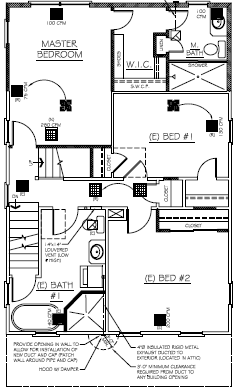

[Proposed Plans]
The Dream:
Create an all-day, every-day living space that every member of the family is able to enjoy.
The Timeline:
March 11, 2019 – June 3, 2019
Week 1: Demo Phase 1, Excavation, Concrete/Masonry, Building Inspection
Week 2: Demo Phase 2, Framing Phase 1
Week 3: Roofing, Siding, Exterior Window & Door Installation, Rough Trades, Framing Phase 2
Week 4: Rough Trades, Rough Inspections
Week 5: Insulation
Week 6: Drywall
Week 7: Drywall, Interior Door Installation,
Week 8: Exterior Stairs and Deck Installation
Week 9: Tile, Cabinetry
Week 10: Cabinetry, Interior Trim
Week 11: Interior Trim, Paint, Appliance Installation
Week 12: Finish Trades, Carpet Installation
Week 13: Final Inspections
The Progress (updated weekly)
Week 1:
All pre-construction site checks and inspections have been completed.
Week 2:
Week 2 started very strong, with little to no issue. Unfortunately, the weather was not kind. The project was halted due to 2 full days of rain.
Week 3:
The project is moving smoothly with framing wrapping up. The project is behind schedule due to two days of rain in the previous week.
Week 4:
Week 4 had a very rough start. We had multiple days of bad weather that caused additional project delays. This put us exactly on week behind schedule.
Week 5:
During Week 5 our team was able to complete all rough trades and install Siding.
Week 6:
Week 6 was an extremely successful week. Insulation, Gutter and Fascia installations were completed along with Rough Trade inspections. Allowing us to Prep Drywall.

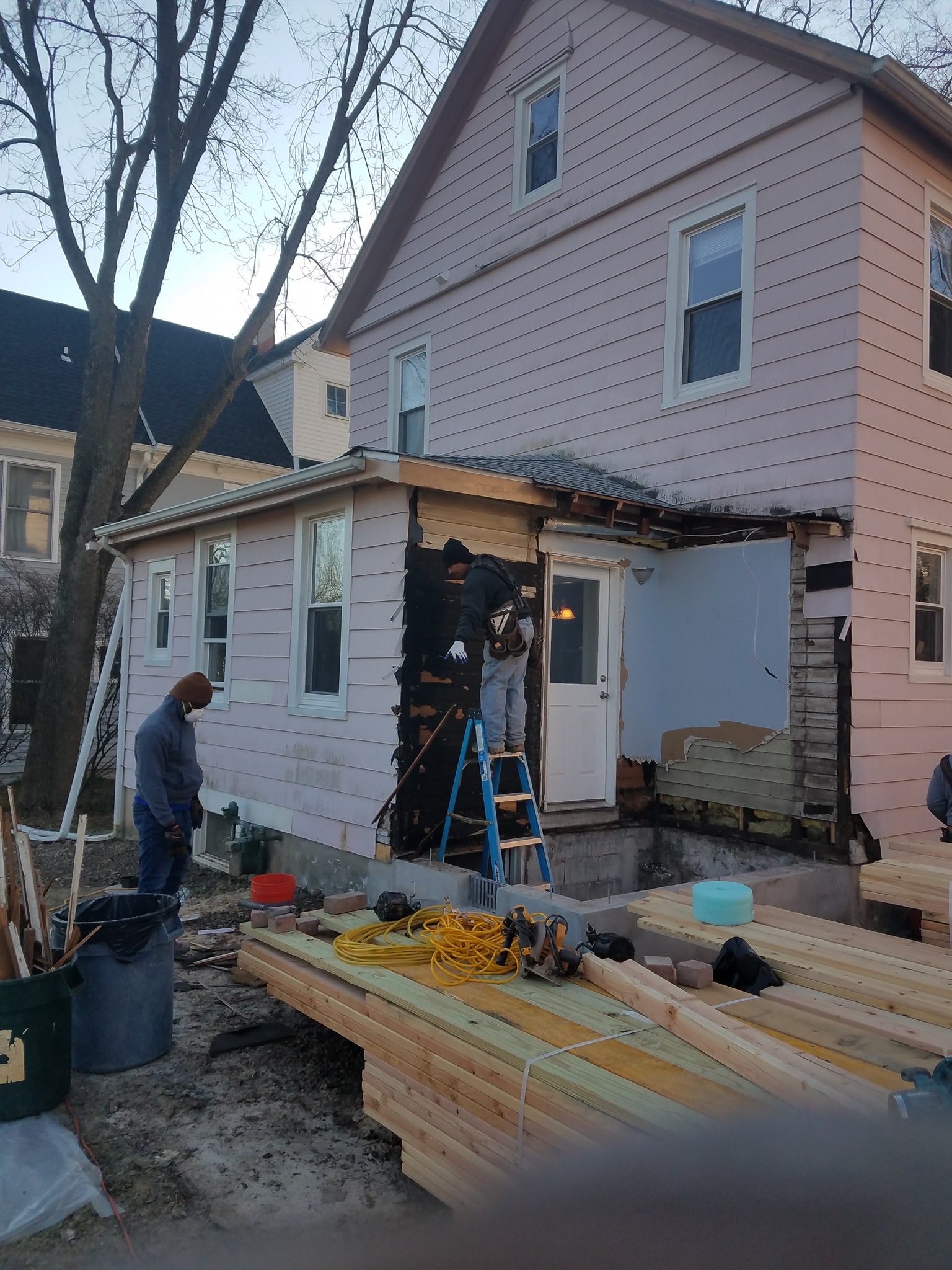

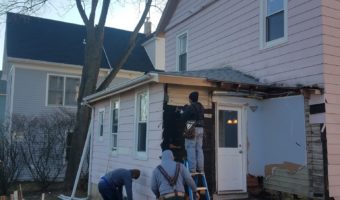

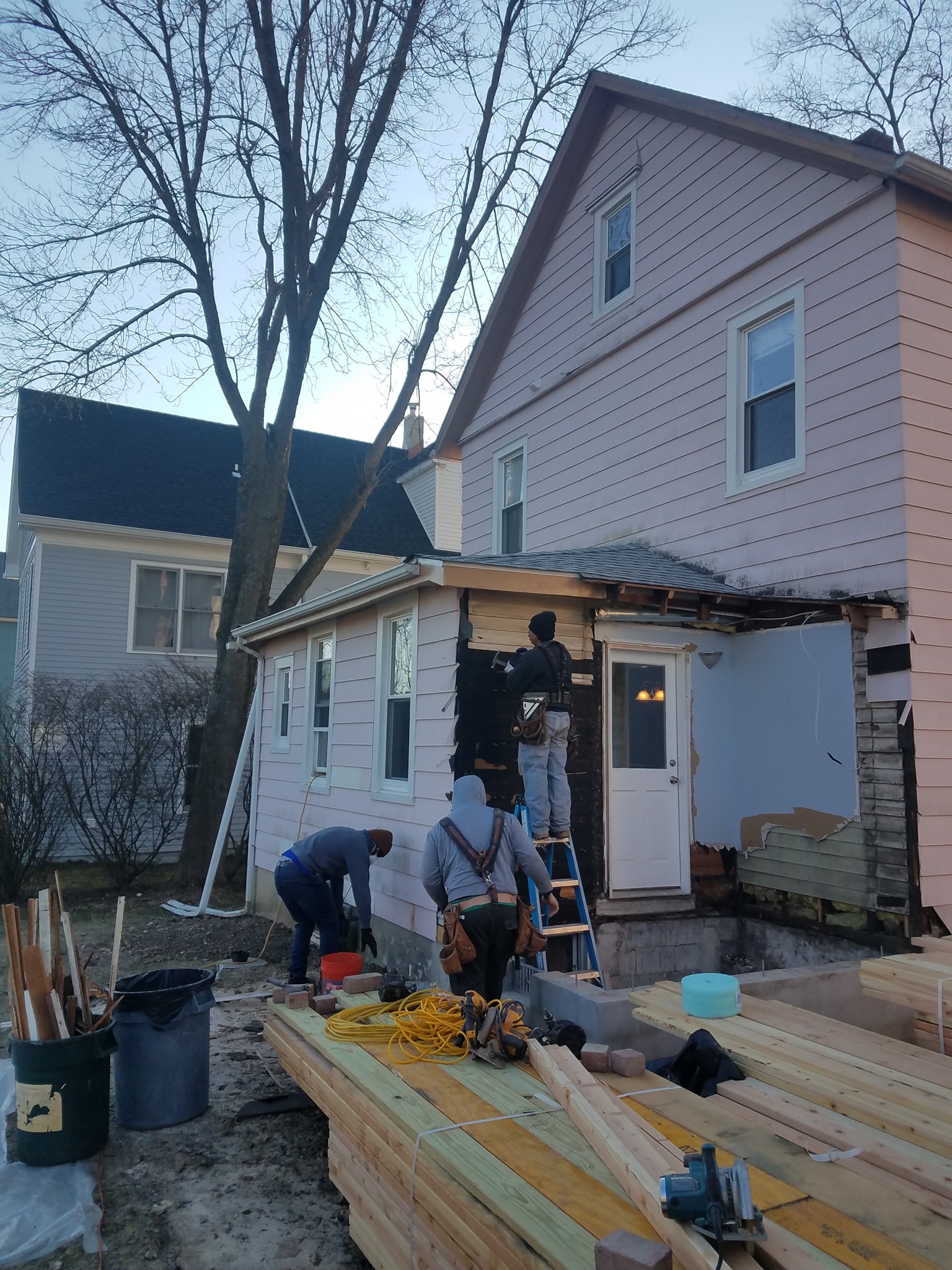

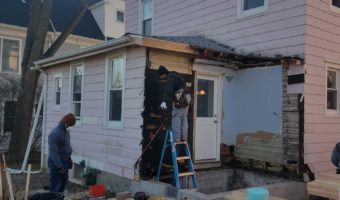

Progress Photos
Week 7:
Drywall installation is underway and is scheduled to be completed during week 8.
Week 8:
Drywall and Interior door installations were completed. Exterior stair and Deck Installations has begun. Tile is prepped for next week’s installation.
Week 9:
The deck installations was completed. Interior Trim & Millwork have begun and is scheduled to be completed on Tuesday Morning. Tile work had multiple delays and is now behind schedule. As a result, Cabinetry Install is also behind schedule.
Week 10:
Tile and Cabinetry installations have been completed. Interior Trim is now underway.
Week 11:
Appliance and Interior Trim installations have been completed. The walls have been prepped and primed (homeowners decided to paint the home themselves.)
Week 12:
All final trades installations are underway.
Week 13:
All Final trade installations are now complete.
Week 14:
The wrong carpet was shipped to job site. We are currently waiting for the correct carpet to be delivered.
Week 15:
Carpet was installed with no issue. All final inspections were passed.
